ADU Timeline
How Long Does It Really Take to Permit and Build an ADU in California?
If you’re planning to build an ADU in California, the most important question isn’t cost — it’s time. Here’s what current Bay Area data shows about how long permitting and construction actually take, and how that compares to building a brand-new house.
In this article
- How long does it take to get an ADU permit in California?
- Why has ADU permitting slowed down?
- Why does the city matter more than the state law?
- How long does it take to build an ADU after the permit is issued?
- How does this compare to building a new single-family home?
Before you ask, here is the source of all these gems: California HCD Annual Progress Report data, 9-county Bay Area, 2022–2024. Permit-year cohort. Processing time = days from application submission to building permit issuance.

How long does it take to get an ADU permit in California?
The median Bay Area ADU now takes 182 days — about six months — to go from a submitted application to an issued building permit. That number comes from California Department of Housing and Community Development (HCD) Annual Progress Report data covering 5,583 matched ADU permits across the nine-county Bay Area in 2024.

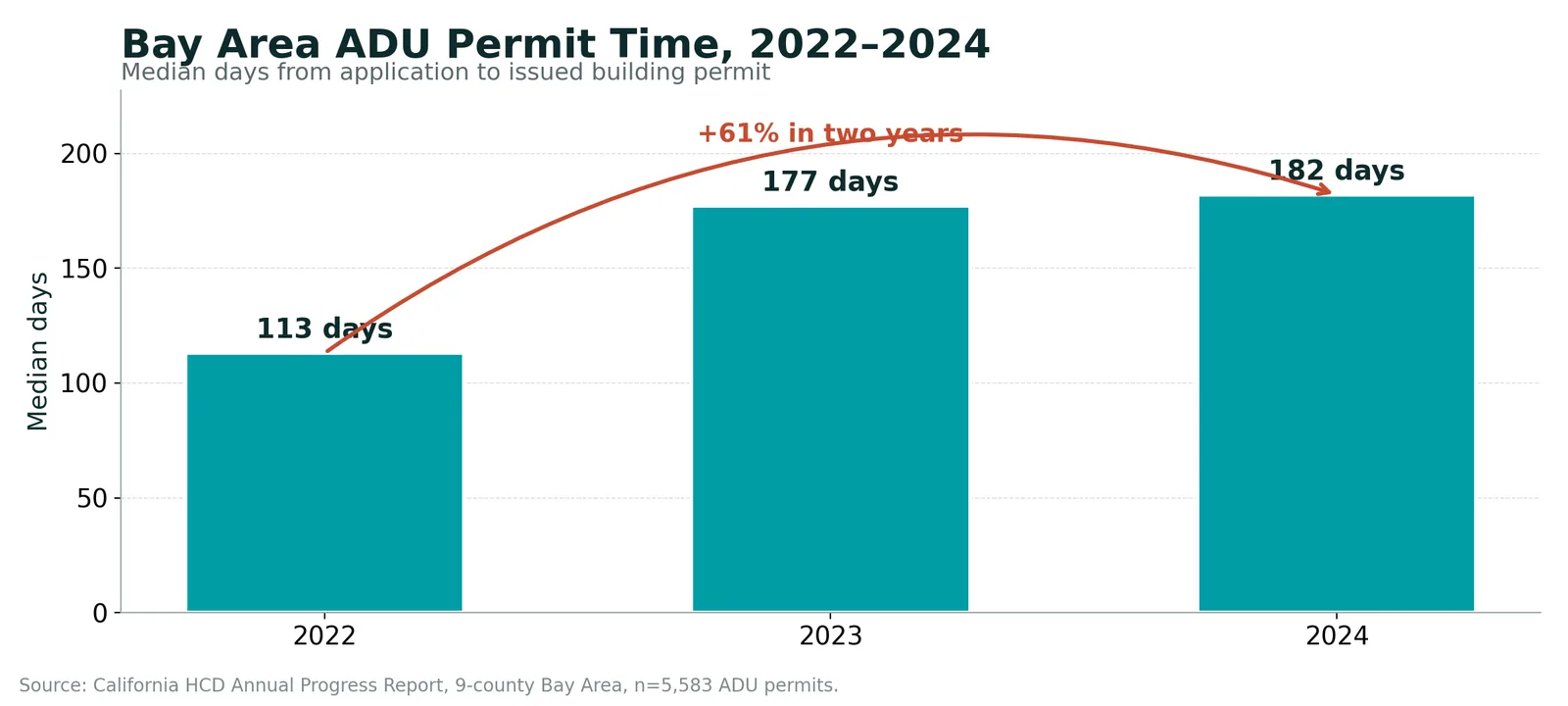

Two years earlier, the median was just 113 days. That’s a 61% increase in 24 months, or roughly 10 extra weeks of waiting. The good news: most of the slowdown happened between 2022 and 2023. From 2023 to 2024, the median moved only five additional days, which suggests the system has settled into a new, slower baseline rather than continuing to deteriorate. For homeowners, that means you can plan around a roughly six-month permit window in most Bay Area cities — but you should not assume your project will be the fast outlier.


Why has ADU permitting slowed down?
Two things changed at once.
First, ADU volume exploded. Matched ADU permits in the data more than doubled, from 1,167 in 2022 to 2,496 in 2024.
Second, cities had to absorb a wave of new state laws — SB 9, AB 2221, AB 976, AB 1033 — each of which forced redesigns to intake, plan check, and inspection workflows.
Plan checkers are now reviewing roughly twice as many applications under more rules, often without staffing increases to match. Even so, the fact that median processing time has held steady since 2023 — while volume kept climbing — is real evidence the system is finding a new equilibrium rather than collapsing.

Why does the city matter more than the state law?
California’s ADU streamlining statutes are statewide, but enforcement is local. The same rules produce wildly different timelines depending on which counter you walk up to:

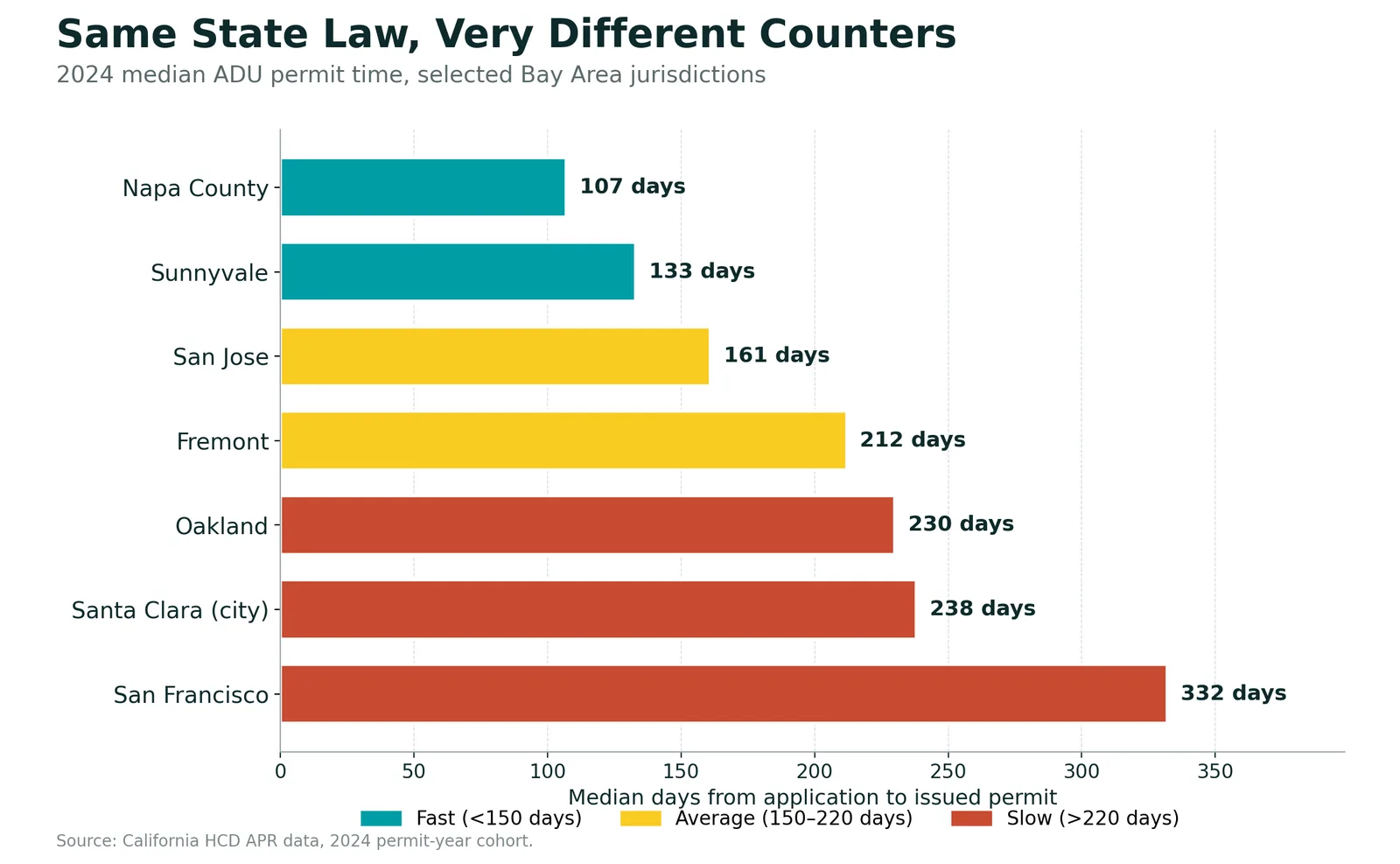

Sunnyvale: 133 days. Napa County: 107 days. San Jose: 161 days. Oakland: 230 days. Santa Clara (city): 238 days. San Francisco: 332 days — nearly 11 months at the median.
Same state law, very different counters. If you have a parcel that straddles a jurisdictional boundary, or you’re choosing between properties, this single factor can add or subtract six months from your project. Before you sign with a designer, ask them: “What’s your average permit timeline in this specific city?”
Another shortcut is using plans that were already used and built in other cities.

Trending
ADU Plans

How long does it take to build an ADU after the permit is issued?
Permitting is only the first half of the timeline. Once your building permit is in hand, expect roughly:
Site-built (stick-frame) ADU: 5 to 9 months.
Modular ADU: 3 to 5 months on site after factory build.
Garage conversion: 3 to 6 months.
Junior ADU within existing space: 2 to 4 months.
These ranges depend heavily on weather, foundation type, utility connections, and contractor backlog. Inspections add unavoidable pauses — most jurisdictions require 6 to 10 separate inspection stops, each typically scheduled 3 to 7 days in advance.
A realistic, all-in timeline for a Bay Area ADU in 2026 looks like this: one to three months for design and pre-application work, six months for permitting, and six to nine months for construction. End-to-end, you should plan on roughly 13 to 18 months from “I want to do this” to “I have a finished unit.” Modular shaves a few months off the construction window; site-built sits at the longer end.

How does this compare to building a new single-family home?

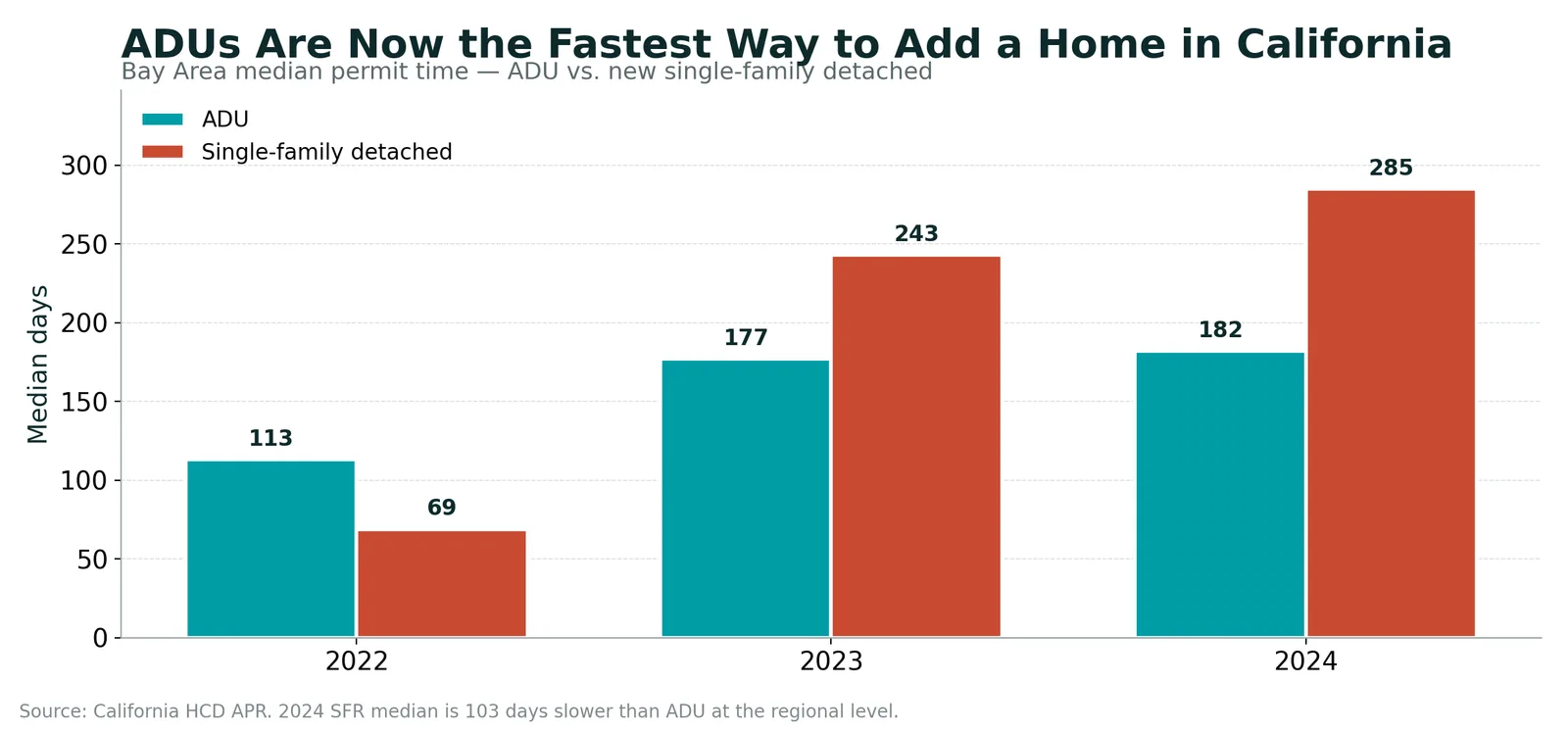

If ADU timelines feel long, building a brand-new house now takes far longer. The same HCD data shows the median Bay Area single-family detached permit took 285 days in 2024 — 103 days, or more than three months, slower than the median ADU.
In Marin County, new houses median 438 days. In San Francisco, 748 days. Between 2022 and 2024 the ADU pipeline added about 10 weeks of wait; the single-family pipeline added about 31 weeks. The takeaway: California’s ADU laws are clearly working relative to the alternative. New houses still face the full traditional review — planning, building, public works, utilities — and that pipeline has not been streamlined. An ADU is, by a wide margin, the fastest way to add a home in California today.

Frequently Asked Questions
No — but you can often pull a separate demolition or grading permit and prepare the site while the building permit is still under review. Talk to your designer about sequencing.
Where this data comes from?
Source: HCD Annual Progress Report data (Table A applications joined to Table A2 building permits), 9-county Bay Area. Processing time = days from application submission to building permit issuance. 5,583 matched ADU records and 2,175 matched SFD records across 2022, 2023, and 2024 (permit-year cohort).
Apologies for possible deviations. The main data principle of “rubbish in – rubbish out” works on housing data too.
Matching is imperfect: only about 60% of Bay Area applications link to a Table A2 permit using jurisdiction + tracking ID + APN. The 9,157 matched records were checked for data errors (negative processing days, n=655 excluded). An A2-only cross-check (entitlement-date → permit-date within a single row) confirms the same directional trends, so the findings are not a join artifact.
Two Bay Area cities — Berkeley and San Mateo (city) — appear to have inaccurate data because they report hundreds of permits each year in Table A2 but very few applications in Table A. This is an APR-reporting gap on the city’s end, not a permit-processing issue. They’re excluded from city-level analysis but their permit volume shows up in county totals.
SFD data is thinner than ADU data at the city level — most Bay Area cities permit fewer than 10 new single-family homes per year, so city-level SFD year-over-year comparisons are unreliable. The ADU-vs-SFD analysis in Section 3 uses county-level roll-ups only to ensure each cell has enough sample to be meaningful.
